KRB CONCEPTS
Building Your Visions

What to Expect During a Kitchen Remodel: A Week-by-Week Timeline

From free consultation to final walkthrough — a real Snohomish County timeline  |  Published April 2026

Written by Jason Miller

Owner & Licensed General Contractor, KRB Concepts

WA General Contractor License: KRBCOC893PS  |  Licensed, Bonded & Insured

Jason has personally managed kitchen remodeling projects across Snohomish County for over a decade. The timelines in this guide reflect the actual project schedules KRB Concepts builds for clients in the Everett area — including real permit review windows, lead times from our current suppliers, and construction durations from completed projects.

Why Trust This Guide?

The timelines in this guide are not generic national estimates. They are built from KRB Concepts’ actual project schedules in Snohomish County, accounting for:

  • Real pre-construction durations: Consultation, PSA, showroom selections, and scope development timelines from our completed projects in 2023–2026.
  • Actual City of Everett permit review windows: Based on current turnaround times we’ve experienced submitting permits for kitchen remodeling projects in Everett.
  • Real material lead times: Cabinet, countertop, and tile lead times from Wellborn Cabinets, Cabinets by Karman, and MSI Surfaces — our active suppliers.
  • Actual construction durations: Week counts from KRB kitchen remodels by scope tier, not industry estimates.

Timelines shift as permit offices, supplier lead times, and trade availability change. We update this guide periodically. When in doubt, request a free consultation for a project-specific schedule.

The most common timeline mistake homeowners make is assuming the remodel starts the day they hire a contractor.

It doesn’t. By the time a KRB Concepts kitchen project breaks ground, we’ve spent 6–10 weeks in pre-construction — designing, selecting materials, finalizing scope, submitting permits, and ordering cabinets. That pre-construction phase is not waiting around. It’s the work that prevents the chaos, cost overruns, and mid-project surprises that give remodeling its bad reputation.

This guide gives you the full picture: every phase, every week, and every decision point from your first call to your final walkthrough — based on how KRB Concepts actually manages kitchen remodeling projects in Snohomish County.

Quick Answer: How Long Does a Kitchen Remodel Take in Snohomish County?

Total project duration (pre-construction through final walkthrough) by scope:

Note: These totals include pre-construction (design, selections, permitting, ordering). Construction alone is typically 6–14 weeks depending on scope. Read on for the full week-by-week breakdown.

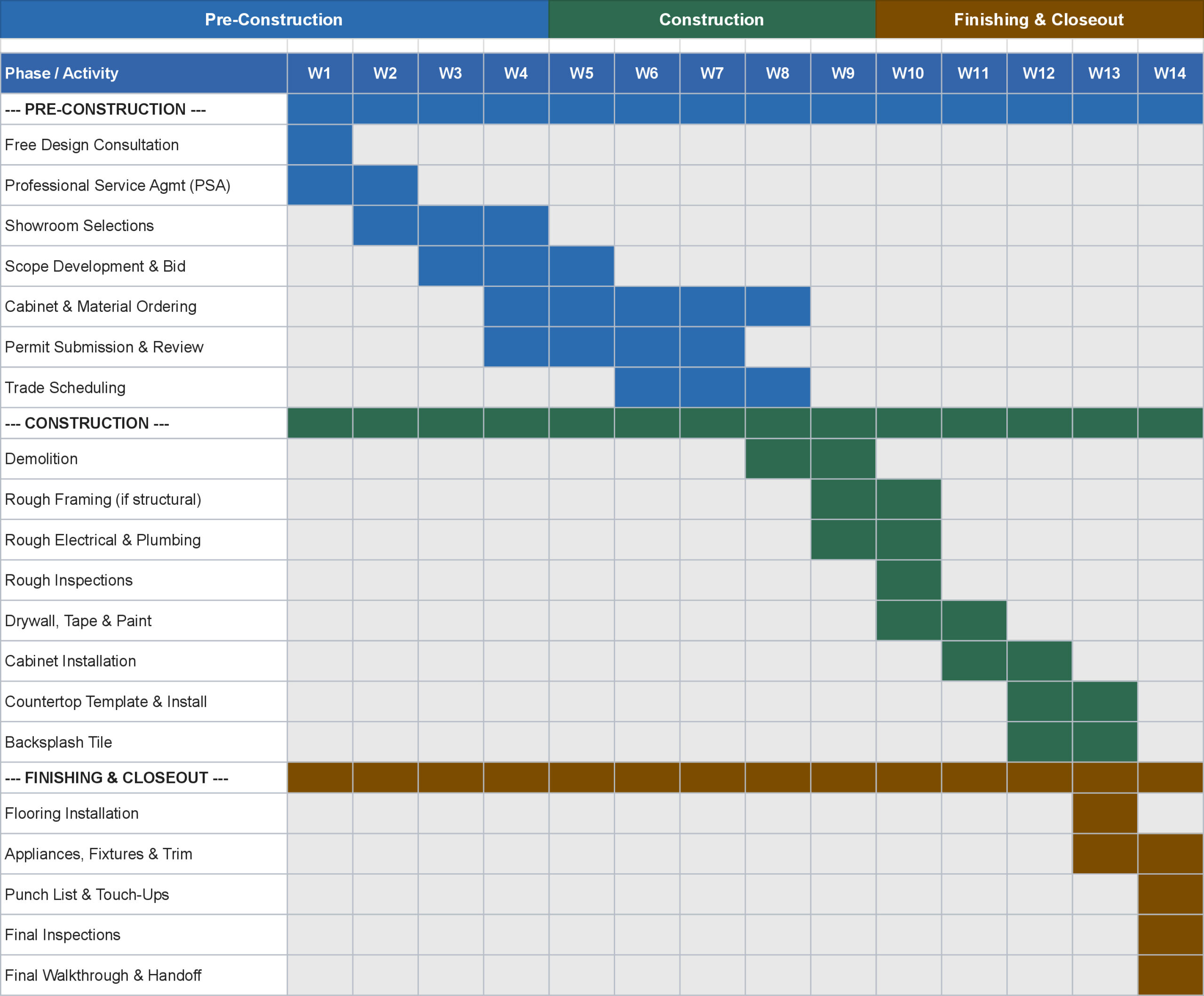

Kitchen Remodel Timeline at a Glance — Snohomish County

The table below shows a typical mid-range KRB kitchen remodel with layout changes and permit requirements. Adjust pre-construction by 2–4 weeks for cosmetic-only projects (no permits). Adjust construction by 4–8 weeks for luxury or high-complexity builds.

Note: Week numbers are illustrative of a 14-week construction timeline. Pre-construction weeks begin at Week 1 (consultation). Add 2–4 weeks for longer permit review. Cosmetic remodels without structural permits compress to 8–10 weeks total.

Phase 1: Pre-Construction — Weeks 1 Through 7 or 8 (Mid-Range Remodel)

Pre-construction is where a remodel is won or lost. The homeowners who have the smoothest construction experiences are almost always the ones whose pre-construction phase was handled thoroughly. Shortcuts here create problems — mid-project change orders, delayed material deliveries, failed inspections — that cost more time and money than they saved.

Week 1: Free Design Consultation

  • Meet with KRB at your home or our Everett showroom to walk your kitchen and discuss your goals.
  • We review the existing layout, note structural constraints, plumbing and electrical locations, and ceiling conditions.
  • We discuss realistic investment ranges for your scope — no pressure, no commitment, just honest information.
  • You leave knowing whether your goals are achievable at your budget, and what your choices are if they’re not.

From the Jobsite

The consultation is where we find the surprises before they become problems. We’ve walked into kitchens that looked like a straightforward cabinet swap and found that the soffit was hiding original 1950s knob-and-tube wiring that needed replacement before any remodel could proceed safely. Catching that in Week 1 is a scheduling inconvenience. Finding it during demo in Week 9 is a budget and timeline crisis. The walkthrough matters.

Weeks 1–2: Professional Service Agreement (PSA)

  • We develop a formal design plan and scope document — the PSA — outlining the project vision, design intent, and investment range.
  • This document protects you: construction work does not begin until both parties agree on scope in writing.
  • Most contractors skip this step and jump directly to a bid. KRB does not. The PSA is what makes our no-surprises process actually work.
  • PSA development and review typically takes 5–10 business days.

Weeks 2–4: Showroom Selections

  • You visit KRB’s design center at 2815 Baker Ave in downtown Everett for guided selections.
  • Our team walks you through every finish: cabinet door styles and finishes, countertop materials, backsplash tile, flooring, hardware, and lighting.
  • All choices are made with real samples in a guided environment — not from a catalog at home alone.
  • Typical selection appointments take 2–4 hours. Most clients complete selections in 1–2 visits.
  • Decision: All selections must be finalized and signed off before cabinets are ordered. This locks your project and prevents future change orders.

From the Jobsite

Selection delay is the #1 cause of pre-construction overruns we see. Clients who are undecided between two countertop options can hold up the cabinet order — and therefore the entire construction start date — by weeks. We mitigate this in our showroom by narrowing choices down to the two or three options that actually work together, rather than presenting 40 options and leaving the homeowner to figure it out. Guided selection is not just a nice experience feature. It’s a project management tool.

Weeks 3–5: Scope Development & Final Bid

  • With selections finalized, we develop the full, itemized construction scope and bid.
  • Every line item is documented: labor, materials, subcontractor scope, permit costs, and contingency.
  • You receive a complete bid before any construction money is spent or work begins.
  • Review, ask questions, and request adjustments during this phase — it’s far easier to modify scope on paper than mid-construction.

Weeks 4–7: Permit Submission & Review (City of Everett)

  • KRB submits permit applications to the City of Everett for all required work (structural, electrical, plumbing, if applicable).
  • Cosmetic remodels with no structural or MEP changes: no permits required — skip this step.
  • Current City of Everett permit review turnaround (2026): 3–6 weeks for standard kitchen permit packages.
  • We submit during the bid development phase to avoid waiting after selections are locked.
  • Construction cannot begin until permits are issued and posted at the job site.

From the Jobsite

Permit timing is the one pre-construction variable we don’t fully control — the City of Everett’s review queue moves at its own pace. What we do control is submitting early. We never wait until selections are complete to submit. We submit the structural and MEP permit package as soon as the design is clear enough to document, even if countertop selections are still in progress. That overlap is what keeps projects on schedule.

Weeks 4–8: Cabinet & Material Ordering / Trade Scheduling

  • Cabinets are ordered as soon as selections are signed off — typically Week 4 or 5.
  • Wellborn Cabinets and Cabinets by Karman current lead times (2026): 4–6 weeks from order to delivery.
  • Countertop slabs are reserved from MSI Surfaces; templates are cut after cabinets are installed.
  • Tile, flooring, and lighting are ordered and staged for delivery at the appropriate construction phase.
  • Subcontractors (electricians, plumbers) are scheduled for their trade phases during this window.
  • Construction start date is confirmed once permits are issued and cabinet delivery is scheduled.

Phase 2: Construction — Weeks 8 Through 13 (Mid-Range Remodel)

Construction is the visible phase — but by this point, the decisions are already made. The schedule is set. The materials are ordered. Construction runs smoothly when pre-construction was handled well. When it wasn’t, construction is where the problems surface.

Week 8–9: Demolition

  • Existing cabinets, countertops, flooring, and fixtures are removed.
  • Plumbing and electrical rough-in locations are exposed for inspection and modification.
  • Structural conditions (existing framing, load-bearing walls) are confirmed with the design plan.
  • Any unforeseen conditions — hidden water damage, outdated wiring, asbestos in older homes — are documented and addressed before rough-in work begins.
  • Demo typically takes 2–4 days for a standard kitchen.

From the Jobsite

Demo is where we find the things nobody knew were there. On one Everett project in the Forest Park neighborhood, we pulled out cabinets in a 1968 home and found the original galvanized plumbing — still functioning, but corroded enough that we recommended replacement before installing the new kitchen. The homeowner agreed. It added cost and a few days, but discovering corroded galvanized pipe behind brand-new custom cabinets two years later would have been far more expensive. We document everything we find in demo and discuss options before proceeding.

Weeks 9–10: Rough Framing, Electrical & Plumbing

  • Structural framing modifications (wall removal, opening reconfiguration) completed and inspected.
  • Rough electrical: new circuits, outlet locations, under-cabinet wiring, and appliance feeds roughed in.
  • Rough plumbing: sink, dishwasher, and any relocated plumbing connections roughed in.
  • New can lights and any structural ceiling changes completed before drywall.
  • City of Everett rough inspections scheduled and completed before drywall closes the walls.

From the Jobsite

Rough inspections are non-negotiable — you cannot close walls until electrical and plumbing rough-in passes inspection. We schedule inspectors early in the week so that if there’s a callback, we have time to correct and re-inspect without losing the whole week. Inspectors in Everett are typically available within 1–2 business days of scheduling.

Weeks 10–11: Drywall, Tape & Paint

  • Drywall is hung, taped, mudded, and sanded.
  • Primer and initial paint coats are applied — a second coat follows cabinet installation.
  • Backerboard and waterproofing are installed behind tile areas.
  • This phase is messy and dusty — we maintain dust barriers throughout to protect adjacent living areas.

Weeks 11–12: Cabinet Installation

  • Base cabinets, upper cabinets, and pantry/specialty units are installed and leveled.
  • Cabinet doors, drawers, and hardware are installed and adjusted for alignment.
  • Crown molding, light rail, and cabinet fillers are fitted.
  • Island or peninsula framing and cabinet installation completed.
  • Countertop templating occurs after cabinet installation is complete — measurements must be exact.

From the Jobsite

Cabinet installation day is the moment the kitchen starts to look real. It’s also where any field conditions — a slightly out-of-level floor, a wall that’s not perfectly plumb — require on-the-spot problem solving. Our installers are experienced with the kinds of quirks you find in Snohomish County homes built between 1960 and 2000. Level, plumb, and scribed to the wall — every time.

Weeks 12–13: Countertops, Backsplash & Flooring

  • Countertop slabs are templated (digitally measured) after cabinets are set — precision is critical.
  • Fabrication and delivery: quartz and granite typically take 7–10 business days from template to install.
  • Countertop installation: sink cutouts, seams, and edge profiles completed.
  • Backsplash tile installation: layout, setting, grouting, and sealing.
  • Flooring installation begins once countertops are in place to protect materials during tile work.

From the Jobsite

Countertop lead time is the pacing constraint for this phase. We template the day after cabinets are set and get the order to the fabricator immediately. If a homeowner decides to change their countertop material after cabinets are installed, it resets the clock — and adds 10–14 days. That’s why we’re firm about locking selections before construction begins. It’s not bureaucracy. It’s protecting your timeline.

Phase 3: Finishing & Closeout — Weeks 13 Through 14

The finishing phase is where the kitchen comes together — and where attention to detail determines whether the finished product feels like a premium remodel or a good one. This is also the phase most vulnerable to being rushed if pre-construction wasn’t handled well and the project is behind schedule. We don’t rush it.

Weeks 13–14: Appliances, Fixtures, Trim & Punch List

  • Appliances are delivered and installed: range, refrigerator, dishwasher, microwave, and hood.
  • Plumbing fixtures installed: sink, faucet, disposal, and dishwasher connections.
  • Electrical trim-out: outlets, switches, under-cabinet lighting, pendant lights, and recessed cans.
  • Final paint touch-ups and cabinet door adjustments completed.
  • Punch list: our project manager walks the space and documents every item that requires attention before final walkthrough.
  • Final inspections scheduled with City of Everett for any permitted work.
  • Final walkthrough conducted with the homeowner — every detail reviewed against the original scope.

Kitchen Remodel Timeline by Project Scope — Snohomish County

Use this table to estimate your total project duration based on scope. All figures reflect KRB Concepts project data and current Snohomish County permit and supplier lead times.

What Can Delay a Kitchen Remodel Timeline in Snohomish County?

Every homeowner wants their kitchen done on time. Here are the most common causes of timeline overruns we see — and how we mitigate each one:

Project Scope

Pre-Construction

Construction

Finishing

Total Duration

Cosmetic Refresh (no permits)

3 – 5 wks

3 – 5 wks

1 wk

8 – 12 wks

Mid-Range, No Layout Change

5 – 7 wks

5 – 7 wks

1 – 2 wks

12 – 18 wks

Full Design-Build w/ Permits

7 – 9 wks

7 – 9 wks

1 – 2 wks

18 – 22 wks

Luxury / Complex Build

8 – 12 wks

10 – 16 wks

2 – 3 wks

22 – 36 wks

Delay Cause

Typical Impact

How KRB Mitigates It

Undecided selections

1 – 3 week delay per open item

Guided showroom process locks selections before ordering begins

Permit review backlog

1 – 4 weeks added to pre-construction

Submit permits early; overlap with bid development

Cabinet lead time increase

1 – 3 weeks if supplier backordered

Order immediately after selections are signed off

Unforeseen site conditions

3 – 10 days per issue

Thorough demo inspection; contingency in schedule

Countertop re-selection

10 – 14 days for re-fabrication

Lock countertop selection before cabinet order

Subcontractor scheduling gap

3 – 7 days between trades

All trades pre-scheduled during pre-construction

Failed inspection

3 – 5 business days for re-inspection

Proactive inspection prep; submit early in the week

Living in Your Home During a Kitchen Remodel

The most common practical question we get: can I stay in my house? Yes — most KRB Concepts clients remain in their homes throughout the kitchen remodel. Here’s how we make it work:

  • Dust barriers: We seal the work area from adjacent living spaces using plastic sheeting and zip-wall systems to contain dust and debris.
  • Job site cleanliness: We clean the job site daily. Debris is removed regularly. Tools are staged, not left strewn across the kitchen.
  • Water access: We coordinate plumbing shutoffs so you know exactly when water will be off and for how long. We minimize no-water windows to the shortest possible duration.
  • Temporary kitchen setup: We recommend setting up a temporary kitchen station (microwave, coffee maker, small refrigerator) in a nearby room before demo begins. A two-to-three month disruption to your kitchen routine is easier when you’ve planned for it.
  • Communication: Your KRB project manager sends regular updates on progress, schedule changes, and upcoming disruptions so you’re never caught off guard.

From the Jobsite

The homeowners who have the smoothest experience living through a remodel are the ones who planned for it in advance. Set up a temporary kitchen the week before demo. Stock paper plates and easy-prep food for the first few weeks. Plan to eat out or get delivery during demo week specifically. By Week 10 or 11 when cabinets go in, the disruption diminishes significantly — you can see the end in sight and the kitchen starts to function partially. The first three weeks are the hardest. It gets better fast.

What KRB Clients Say About the Timeline Experience

“The showroom experience alone was worth it. We made every decision in one afternoon — cabinets, countertops, backsplash — and walked out excited instead of overwhelmed.”

SR

Sarah R.

Full kitchen remodel — Everett, WA

“KRB gave us a real scope and stuck to it. No change order surprises, no budget blowouts. Just a beautiful new bathroom on the schedule they promised.”

MD

Mike & Teresa D.

Master bath remodel — Lynnwood, WA

“We’ve done two projects with KRB. The second was even smoother than the first. That’s how you know a company has a real process — not just a promise.”

JL

Jennifer L.

Kitchen + bathroom — Mill Creek, WA

Frequently Asked Questions — Kitchen Remodel Timeline

How long does a kitchen remodel take in Snohomish County?

Total project duration — from first consultation through final walkthrough — ranges from 8–12 weeks for a cosmetic refresh with no permits, to 18–26 weeks for a full design-build with structural changes and City of Everett permits. Most mid-range KRB kitchen projects complete in 14–18 weeks total. The largest variable is pre-construction: design, selections, permits, and material lead times take 6–10 weeks before construction begins.

How long does construction alone take for a kitchen remodel?

Construction-only duration (from demo to final walkthrough) typically runs 5–7 weeks for a mid-range remodel with no layout changes, 7–10 weeks for a full design-build with structural work, and 10–16 weeks for luxury or high-complexity projects. These timelines assume pre-construction is complete and all materials are ordered and staged before demo begins.

Why does pre-construction take so long?

Pre-construction involves design development, showroom selections (which must be finalized before ordering), scope documentation, permit submission and review, cabinet manufacturing (4–6 weeks from order), and trade scheduling. These steps can’t be skipped or significantly compressed without creating problems during construction. The homeowners who experience the smoothest remodels are the ones who invested time in pre-construction rather than rushing to start demo.

How long does City of Everett permit review take for a kitchen remodel?

As of 2026, standard kitchen remodeling permit packages submitted to the City of Everett typically take 3–6 weeks for review. Simple electrical or plumbing permits may be faster; structural permits with engineering documentation can take longer. We submit permits as early as possible in the pre-construction phase — often while selections are still being finalized — to avoid permit review becoming a bottleneck.

Can I speed up my kitchen remodel timeline?

The most effective way to compress your timeline is to make selections quickly. Cabinet lead time (4–6 weeks) is fixed once you order — it can’t be shortened. But every week you spend deciding on countertop material or cabinet finish is a week added to your total project duration. Coming to your showroom appointment prepared — with photos of kitchens you like and a clear sense of your style direction — dramatically speeds up the selection process.

What time of year is best to start a kitchen remodel in Snohomish County?

There’s no single best season, but fall and winter tend to have shorter trade scheduling lead times than spring and summer when demand peaks. Starting pre-construction in October or November typically allows construction to begin in January or February. If you want your kitchen done by summer, start the pre-construction conversation in January at the latest — permitting and cabinet lead times mean a February design consultation often yields a May or June construction start.

Ready to Start Planning Your Kitchen Remodel?

The best time to start the pre-construction phase is now — before you need your kitchen done. Schedule a free design consultation with KRB Concepts and we’ll walk you through a realistic timeline for your specific project.

About KRB Concepts

KRB Concepts is Everett’s guided design-build remodeling firm, specializing in kitchen remodeling, bathroom renovations, and custom cabinetry throughout Snohomish County. We operate an in-house design center and showroom at 2815 Baker Ave, Ste 200 in downtown Everett, and serve as authorized dealers for Wellborn Cabinets and Cabinets by Karman.

Every KRB project follows the same structured, no-surprises 5-step process — from free design consultation through guided showroom selections, Professional Service Agreement, construction, and final walkthrough. We’ve completed kitchen and bathroom remodeling projects across Everett, Lynnwood, Mukilteo, Mill Creek, Snohomish, Lake Stevens, and surrounding communities.

Credentials: WA General Contractor License KRBCOC893PS  |  Licensed, Bonded & Insured  |  Master Builders Association  |  Everett Chamber of Commerce  |  American Subcontractor Association  |  LeTip International

Contact: 2815 Baker Ave, Ste 200, Everett, WA 98201  |  (425) 314-5614  |  tasha@krbconcepts.com  |  krbconcepts.com
